Transportation

Where the Rubber Meets the Road: The Story Behind Kyle’s 2022 Road Bond

Three years later, construction on the 2022 Road Bonds is underway, and residents may be wondering: how did we get here?
Aerial view of cars lined up in traffic on a two-lane road, with construction signs, orange cones, and traffic lights on one side. Trees and houses are visible on both sides of the road.

In November 2022, Kyle voters approved the largest road bond in the city’s history. Proposition A set aside $294 million for major road improvements aimed at easing traffic, improving safety, and supporting Kyle’s rapid growth. Now, three years later, construction is underway, and residents may be wondering: how did we get here?

Kyle has been one of the fastest-growing cities in Texas. From 2010 to 2020, the population grew by over 60 percent. But many of the area’s roads, especially those on the east side that were originally built as rural county roads, weren’t designed to handle the increased traffic volumes. Some of these roads are managed by Hays County or TxDOT, which limits the City’s ability to make improvements. On the roads the City does oversee, residents have consistently identified congestion and poor roadway conditions as top concerns in annual surveys.

These concerns didn’t go unnoticed and in 2013 voters approved a $36 million road bond package. A few years later, it was clear that those earlier road improvements had not kept pace with Kyle’s growth and traffic concerns persisted. In response, city leaders began exploring a larger, more comprehensive bond. Planning for that bond formally began in 2021. The City Council worked with engineers and a public engagement team to identify which roads needed the most help. They studied traffic patterns, safety data, and growth projections. After several public meetings, city staff and consultants proposed eight projects that would improve key east-west and north-south routes within the city’s jurisdiction.

In November 2022, voters approved Proposition A with nearly 65 percent in favor. The strong support reflected broad agreement across the community that Kyle needed long-term transportation solutions. With voter approval in hand, the city got to work turning plans into real projects.

2022 Road Bond Projects

Project NameScope at a GlanceEstimated Construction Start
Marketplace Ave ExtensionCreates a new north–south connection and improves access to retail areasCompleted
Bebee RoadWidens major east-side corridor to four lanes for added capacityUnder construction
(since late 2025)
Kohlers to SetonBuilds new I-35 underpass and east-side connection to Seton ParkwayUnder construction
(since late 2025)
Bunton Creek RoadWidens Bunton Creek to four lanes and improves safety near schools and neighborhoodsWinter 2025/26
Center StreetRebuilds and widens downtown corridor for safer, smoother travelFall 2026
Old Stagecoach RoadWidens roadway and upgrades intersections for safer neighborhood accessSpring 2026
Kyle Pkwy / Lehman Rd ExtBuilds new extensions to improve north–south travel and reduce school trafficSummer 2026
Windy Hill RoadWidens roadway and adds sidewalks and safety featuresWinter 2025/26

These projects were selected for their ability to reduce congestion, improve emergency response times, and get Kyle moving. They go far beyond resurfacing or minor upgrades. Several projects involve expanding two-lane rural roads into full corridors, with center turn lanes, sidewalks, bike paths, lighting, and upgraded drainage systems. Others are entirely new roads, representing greenfield construction that creates new east-west and north-south connections. Most include sidewalks, trails, and safer intersections. Five of the eight are on the east side of Kyle, where much of the city’s growth is happening.

Many residents wonder why some existing, heavily congested roads are not being rebuilt first. The reason comes down to readiness. Some projects, like Marketplace Avenue or the west end of Bebee Road, required fewer right of way acquisitions or had simpler utility work, which allowed them to move into construction sooner. Other roads, especially older ones with dense utilities or nearby homes and businesses, need more coordination with property owners, engineers, and partner agencies before work can begin. Starting each project as soon as it is ready keeps the entire program moving instead of waiting for the most complicated roads to clear every step first.

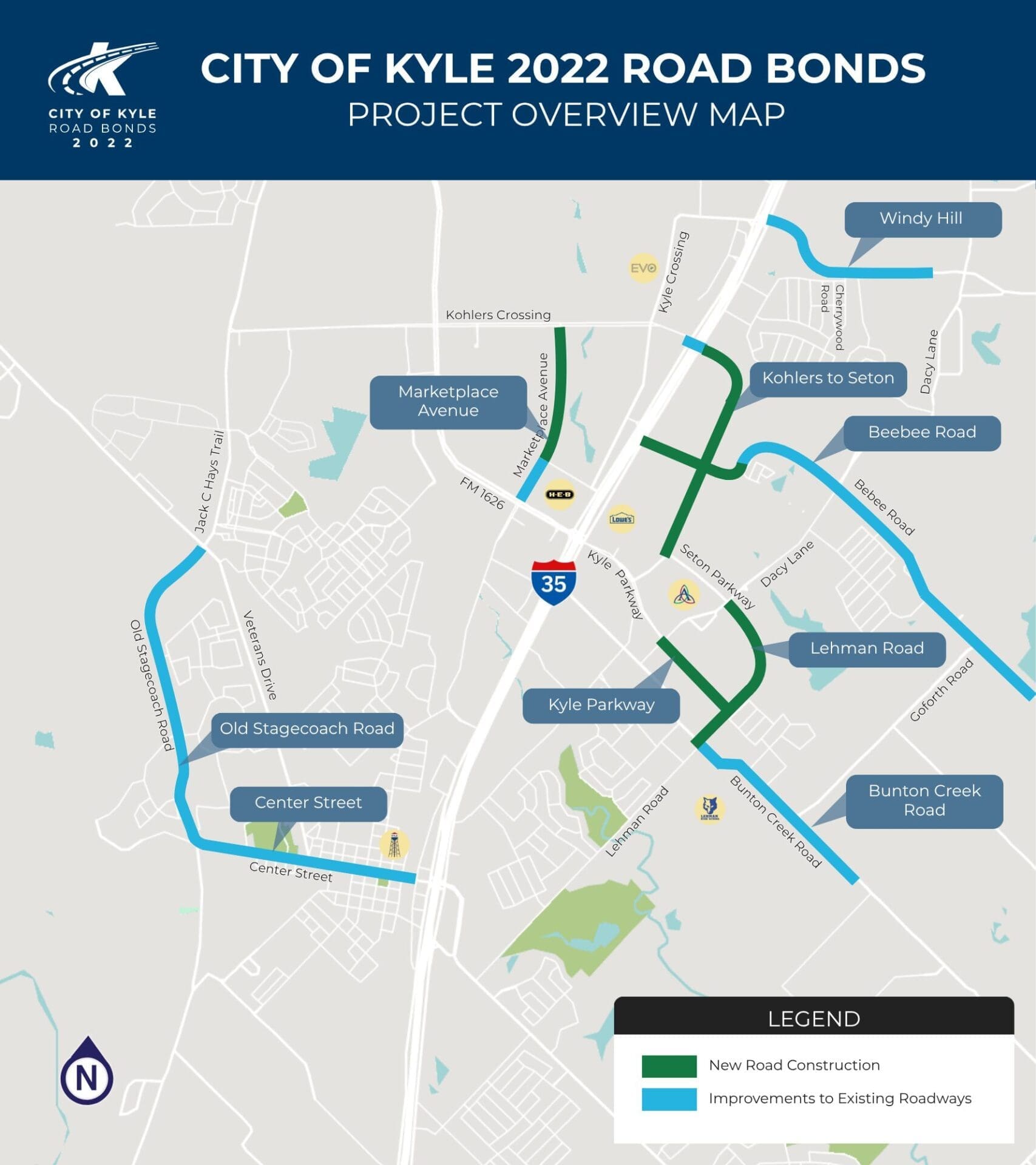

Map of Kyle, Texas showing 2022 road bond projects. Green lines indicate new road construction and blue lines show improvements to existing roads, labeled by name, with a legend and north arrow included.
This map shows the eight road projects funded by the Road Bond. Green lines mark brand-new road construction, and blue lines show upgrades to existing roadways. Most projects are located east of I-35.

Road construction doesn’t happen all at once. It moves through several key stages, some of which may overlap depending on the project. Stages include preliminary design, final design (PS&E), right-of-way (ROW) acquisition, utility coordination, permitting, bidding and contracting, and finally, construction.

Road Construction Process: From Planning to Pavement

StageDescriptionTimeframe
Preliminary DesignEarly layouts and feasibility studies that shape the project’s basic structure.3 to 6 months
Final Design (PS&E)Full construction documents and estimates prepared for bidding.6 to 12 months
Right-of-Way (ROW)The city purchases land or easements if more space is needed.A few months to 1+ year
Utility CoordinationWater, gas, internet, and electrical lines are moved ahead of construction.3 to 6+ months
PermittingRequired approvals from agencies like TxDOT or railroad authorities.3 to 9 months
Bidding and ContractingPublic process to select a contractor for the work.2 to 3 months
ConstructionPhysical roadwork begins once a contractor is selected.9 to 24 months

An example of overlapping stages include right-of-way (ROW) acquisition and utility coordination, which often begin while design is still being finalized. So, when a project is listed as in “final design,” it may already be progressing through other stages too.

The first project to cross the finish line was the Marketplace Avenue extension, which opened to traffic in August 2025. Several other projects, including Bebee Road and the Kohlers Crossing to Seton Parkway extension, are now under construction east of the interstate.

Aerial view of a newly constructed, empty road curving through green fields and sparse trees, with commercial buildings and cloudy sky in the background.

Completed Construction of Marketplace Avenue Extension (August 2025)
Aerial view of a road under construction in a dry, open area. Construction vehicles are working on the site, with unfinished roads and cleared land visible. Nearby, buildings and roads are surrounded by open fields.

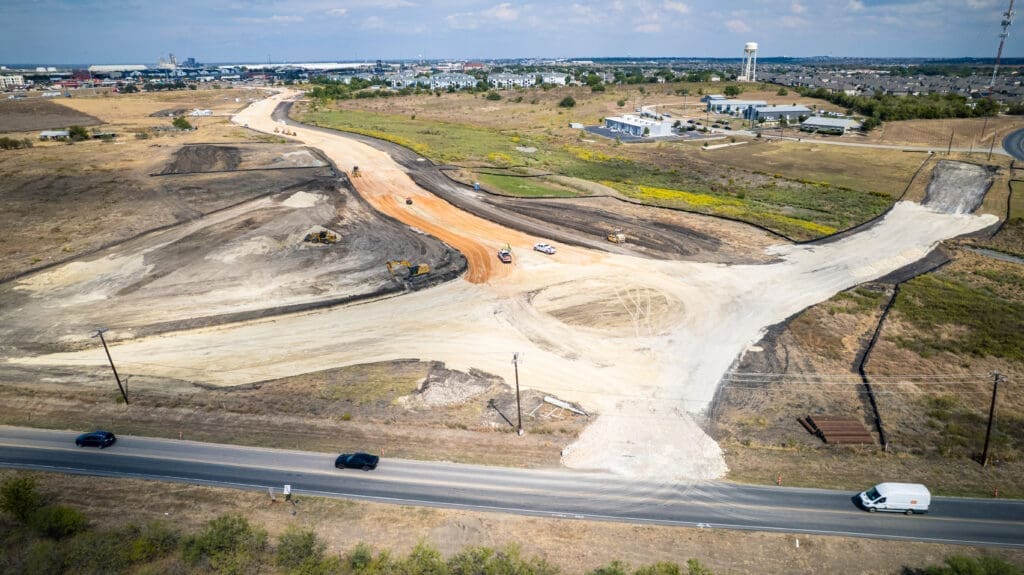

Construction of Kohlers Crossing to Seton Parkway at Bebee Road (October 2025)

Mayor Travis Mitchell said the bond was designed to prepare Kyle for the future. “We absolutely need to build roads, not just any roads, but well-engineered roads, to keep up with Kyle’s growth,” he said.

Not every road in Kyle falls under city control. Some, like FM 150 or portions of Windy Hill, are managed by the state or Hays County. While the city coordinates where possible, the bond projects focus on streets the city owns or can directly improve. At the same time, the Transportation and Public Works Department continues daily repairs, upgrades, and safety work across Kyle. These routine improvements help keep traffic moving while the larger bond projects take shape. Residents can see which roads the city maintains on the street maintenance dashboard.

Curious about what’s next? Updates and maps are available at KyleRoadBonds.com. As more projects break ground in 2026, residents can expect some delays as these new roads are built, but the result will be a safer, better-connected Kyle.
